- Enter descriptions for each event in column A. Column B contains the start date for each
of the event. The start date can be a equal to the end date of an event, so that any
changes to that start date will change this start date. Column C contain the duration for
each event in days. Column D will contain the end date for each event, by adding column B
and C. Column D is not used in the chart.
- Created a stacked horizontal chart for data in A3:C11. The Chart Wizard will probably
guess these series incorrectly, so youll need to set the category axis labels and
data series manually. Set the axis as follows:
category x axis label should be A3:A11
Series 1 data should be B3:B11
Series 2 data should be C3:C11
- Remove the charts legend and adjust the weight of the chart so that all of the
category axis labels are visible.
- Select the data series that corresponds to the data in Column B and right click to
access the Format Data Series dialog box. Set Borders to None and Area to None. This
essentially makes the first data
series invisible.

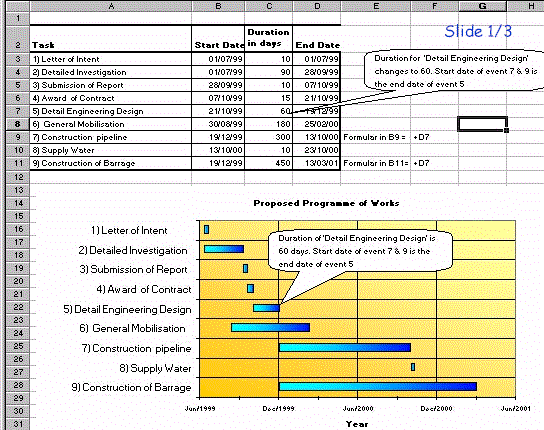

- By now you should have created the program chart. Try to change the duration
of any
event and see how the chart update itself.
- Try to drag the 'Detail Engineering Design' bar, the chart will adjust the start date of
'Construction Pipeline' and 'Construction barrage' start date accordingly.
- The slide show below demonstrate the effect of the dragging the 'Detail Engineering
Design' bar.

The above sample is available for downloading.
